ClustersProjectsTimelineInsights
Buyer Education

Cheapest PSF Is Not Best Value: The Four Variables That Actually Decide What You're Buying

BangaloreSelect Research·2026-04-30·6 min read

₹5,200 psf does not beat ₹6,800 psf if the cheaper project has no road, no confirmed metro line, and no listed builder behind it. PSF is where the analysis starts. Four variables decide whether a PSF is good value — and none of them appear on the price sheet.

Cheapest PSF is not best value — the four variables that decide

₹5,200 psf does not beat ₹6,800 psf if the cheaper project has no road, no confirmed metro line, and no listed builder behind it. PSF is where the analysis starts. It is not where it ends.

The confusion is structural. PSF is a single number. It is easy to compare. Two apartments, two prices per square foot: the lower one feels like better value. That instinct is almost always wrong when applied across clusters or across builder categories.

Four variables decide whether a PSF is good value. None of them appear on the price sheet.

Variable one: builder track record

The builder's delivery history is more important than almost any other single data point in an off-plan purchase. A project that is not completed is worth zero. A project delivered on time adds a meaningful premium at resale.

The listed developers in North Bangalore's active inventory — Birla, Sobha, Godrej, Embassy, Century, Assetz, Puravankara, Tata Housing — have multi-decade delivery records across dozens of projects in Karnataka. Their delay rates, average possession offsets, and unit completion histories are documented in RERA filings and registrar data.

A non-listed developer at a lower PSF may be building a perfectly good project. The point is: the absence of documented delivery history means you are pricing builder risk entirely on your own judgment. That risk is not in the PSF. It is in the probability that the PSF you paid was for a project that completes.

Variable two: infrastructure proximity, confirmed not projected

North Bangalore has three categories of infrastructure in 2026.

Confirmed and operational: the existing Blue Line metro south of Hebbal; the NH-44 airport road; Manyata Tech Park's commercial footprint.

Confirmed and under construction: BMRCL Blue Line Phase 2B (airport extension, target mid-2027); the Karnataka elevated corridors package (Cabinet-approved, ₹13,262 crore, April 2026).

Projected or proposed: various STRR alignments, proposed ring road extensions, developer-claimed infrastructure timelines.

A PSF priced on confirmed infrastructure is different from a PSF priced on projected infrastructure — which is different again from a PSF priced on proposed infrastructure. None of those are inherently wrong. Buying ahead of confirmed infrastructure is how most investors capture appreciation. But the risk profile is completely different.

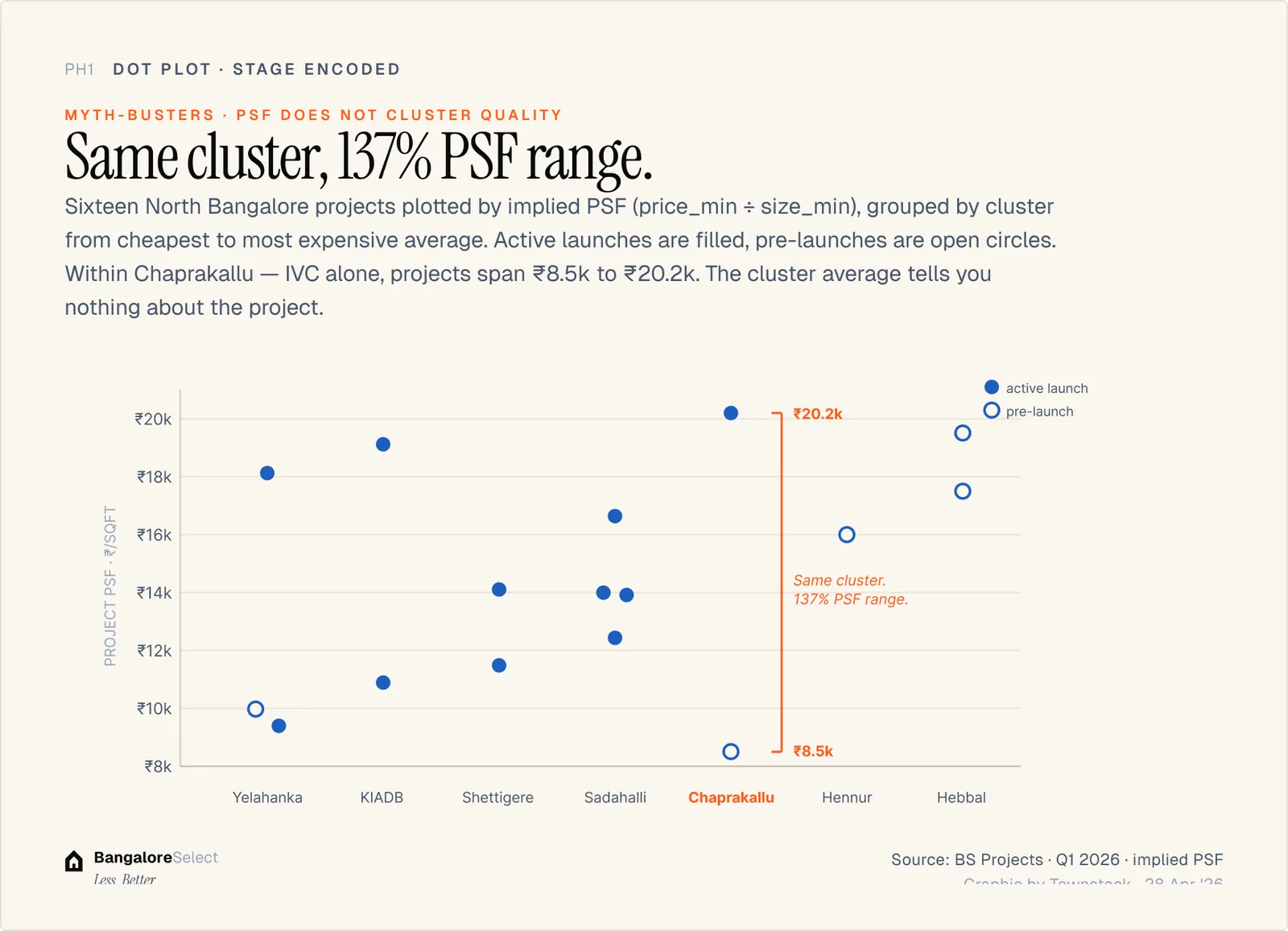

Project PSF distribution — ranked by adjusted value score

Variable three: ticket size relative to buyer pool

A unit at ₹5,200 psf sounds affordable. A 1,500 sq ft apartment at ₹5,200 psf is ₹78 lakhs. That is within the first-time buyer and upgrade buyer segments — a large pool. When you resell, you need a buyer for your specific ticket size at your specific location.

A ₹78-lakh apartment in a North Bangalore cluster with limited infrastructure competes for buyers who have ₹78 lakhs and are choosing between multiple clusters and ticket sizes. A ₹1.02 Cr apartment in the same cluster competes for a buyer who can afford ₹1 Cr and is choosing North Bangalore specifically over alternatives.

The relationship between PSF, unit size, and ticket size determines the depth of your resale pool. Low PSF on large units creates a thin resale market. High PSF on right-sized units in confirmed-infrastructure clusters creates a deeper one.

Variable four: land title and regulatory status

RERA registration is not the same as RERA compliance. A project can be RERA-registered and still have disputed land title, pending BDA approvals, or incomplete sanction drawings.

Karnataka RERA registration numbers follow the format PRM/KA/RERA/1250/... or PRM/KA/RERA/1251/... depending on registration batch. Verify the registration directly at rera.karnataka.gov.in — not from the developer's brochure or sales collateral.

The lower the PSF, the more important this verification becomes. Projects at the bottom of the price curve are more likely to be in pre-approval stages, on disputed land, or outside RERA's registration perimeter.

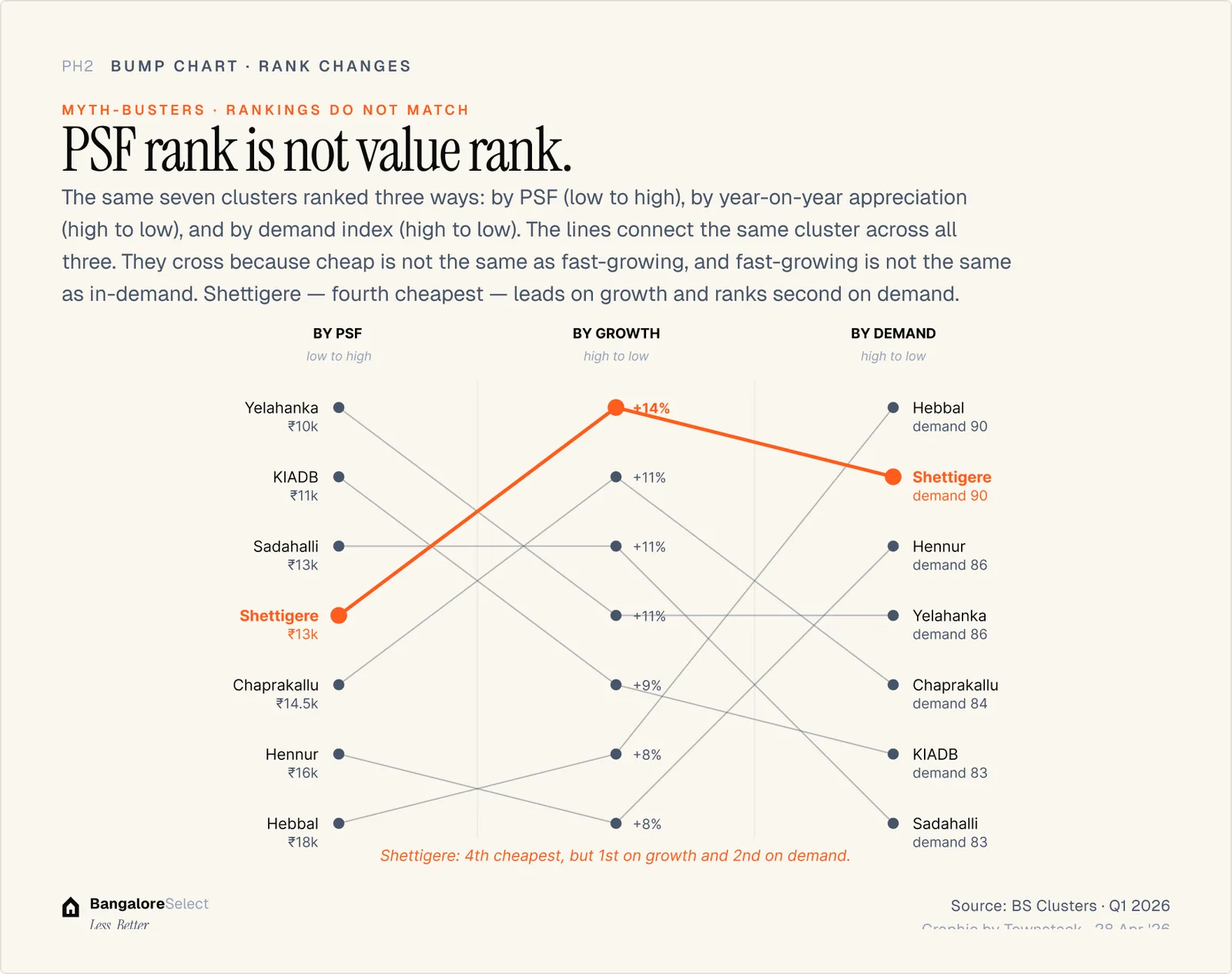

Three-axis ranking — PSF vs infrastructure vs builder track record

What the four variables together tell you

Run four checks on any project before comparing PSFs: What is the builder's delivery record across their last three projects? What infrastructure is confirmed, under construction, or merely proposed within 2 km? What is the all-in ticket size for the unit you are considering, and who is the buyer pool for that ticket? Is the RERA registration current and the land title unencumbered?

A project that scores well on all four at ₹6,800 psf is better value than a project that fails two of them at ₹5,200 psf. The PSF is where the conversation starts.

Sources: Karnataka RERA portal. BMRCL Phase 2B alignment. Karnataka elevated corridors: Cabinet approval, April 2026.
