What December 2027 Means on Hennur Road

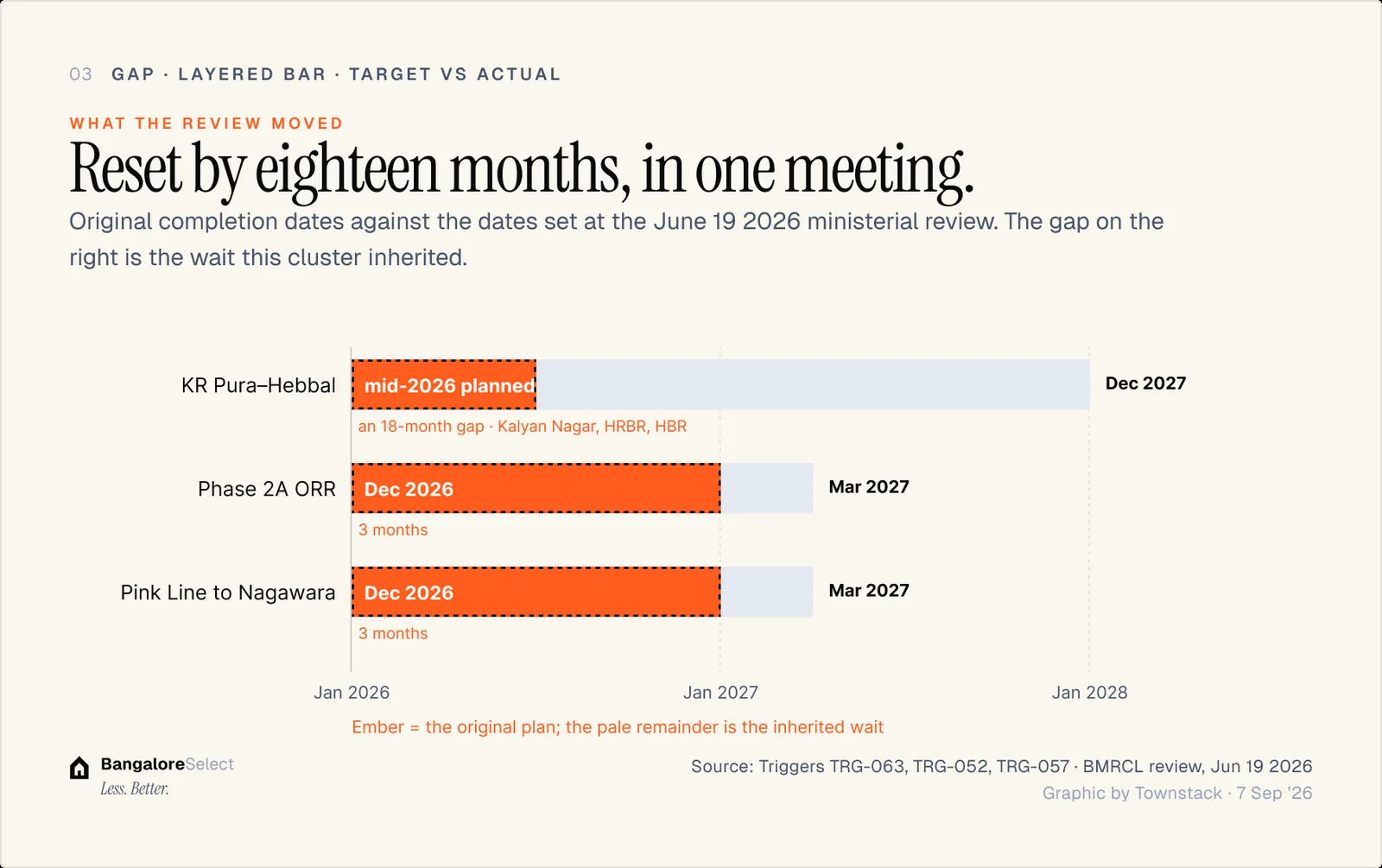

Every cluster watchlist has an organising fact, and Hennur–Thanisandra's arrived in a single meeting. On June 19, 2026, the BMRCL ministerial review reset the entire KR Pura–Hebbal metro segment (Kalyan Nagar, HRBR, HBR Layout, the stations this cluster's map is drawn around) to December 2027. Not a drift.

Every cluster watchlist has an organising fact, and Hennur–Thanisandra's arrived in a single meeting. On June 19, 2026, the BMRCL ministerial review reset the entire KR Pura–Hebbal metro segment (Kalyan Nagar, HRBR, HBR Layout, the stations this cluster's map is drawn around) to December 2027. Not a drift. A reset, announced with a new minister in the chair and no hedging in the minutes.
The eighteen months in front of Hennur are therefore about one question: does the cluster's ₹16,000 hold its shape while the metro premium waits, supported by everything else the corridor has, or does 'everything else' turn out to have been the metro all along?
The desk's read: the else is substantial. Here is its calendar.

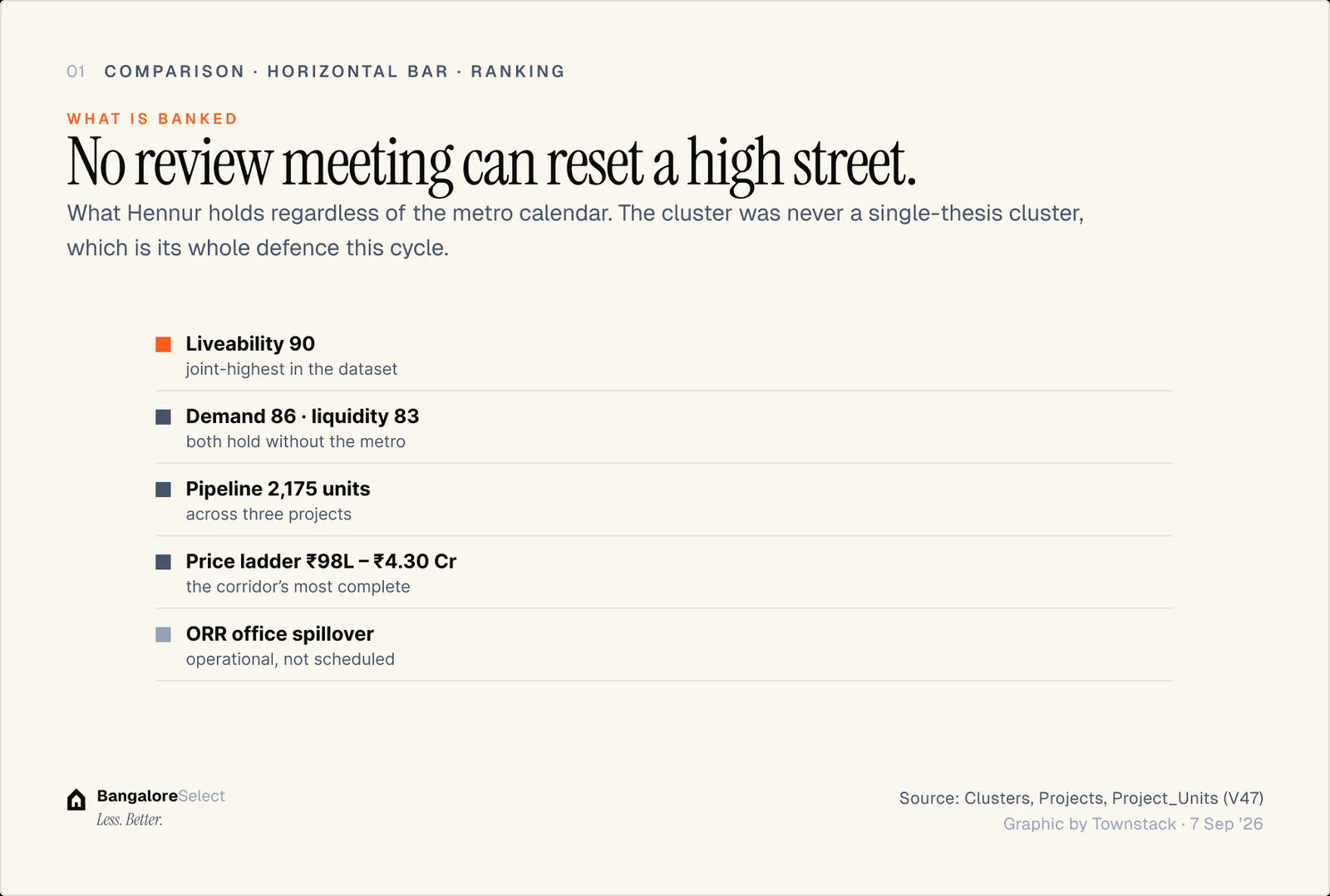

What's already banked
Liveability 90 (joint-highest in the dataset) was earned street by street, and no review meeting can reset it. The ORR office spillover is operational income, not projection. And the cluster's residential book is the corridor's most complete price ladder: Nikoo Thanisandra from ₹98 lakh, TVS Emerald Altura through ₹2.9 crore, Puravankara's Codename Hennur pre-launch to ₹4.3 crore. Hennur never was a single-thesis cluster; that is its whole defence this cycle.

Watch (Q4 2026): the anchor next door

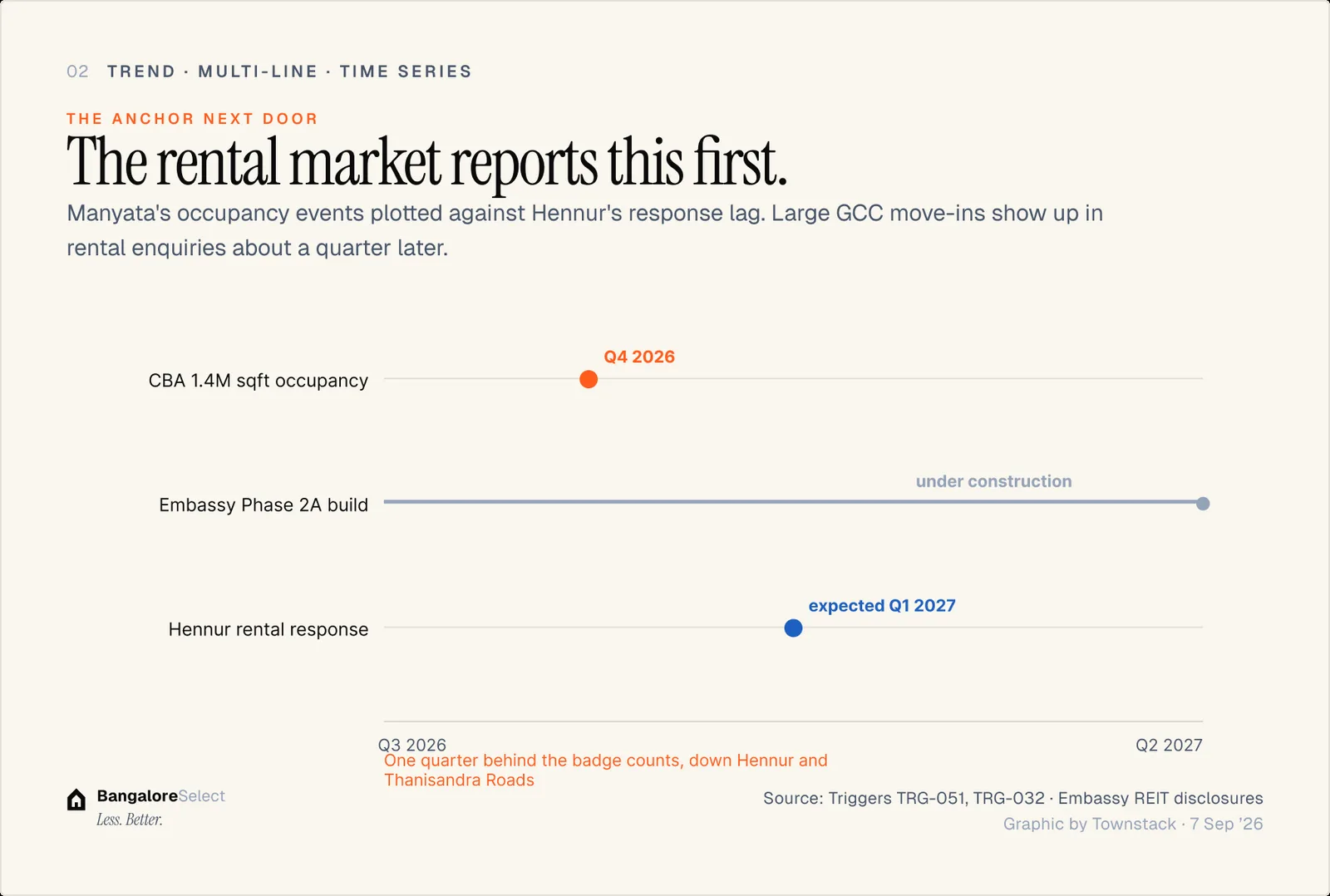

Commonwealth Bank of Australia takes occupancy of 1.4 million square feet at Embassy Manyata this December quarter, and Manyata's catchment drains straight down Hennur and Thanisandra Roads. Watch the same tells as Hebbal's watchers: fit-out completion, badge counts, the rental-enquiry bump that follows every large GCC move-in by about one quarter. Hennur's rental market, more than its sales market, will report this first.
The companion signal is Embassy's Phase 2A million square feet, still under build. A cluster leaning on office demand wants to see both cranes and tenants; this quarter delivers a reading on each.

Watch (March 2027): the other lines
The December 2027 headline obscures that two nearer rail dates still serve this cluster's southern edge. The Pink Line's underground run to Nagawara is set for March 2027, and Phase 2A on the ORR (trial runs ordered from October 2026) targets the same month. Both feed the Nagawara interchange, which is Hennur's practical rail access until its own stations open.
Watch October 2026 specifically: if Phase 2A trials begin on schedule, the March dates hold and Hennur's 'metro-adjacent' claim survives the year intact. If trials slip, assume the whole 2027 rail calendar moves together: it usually does.

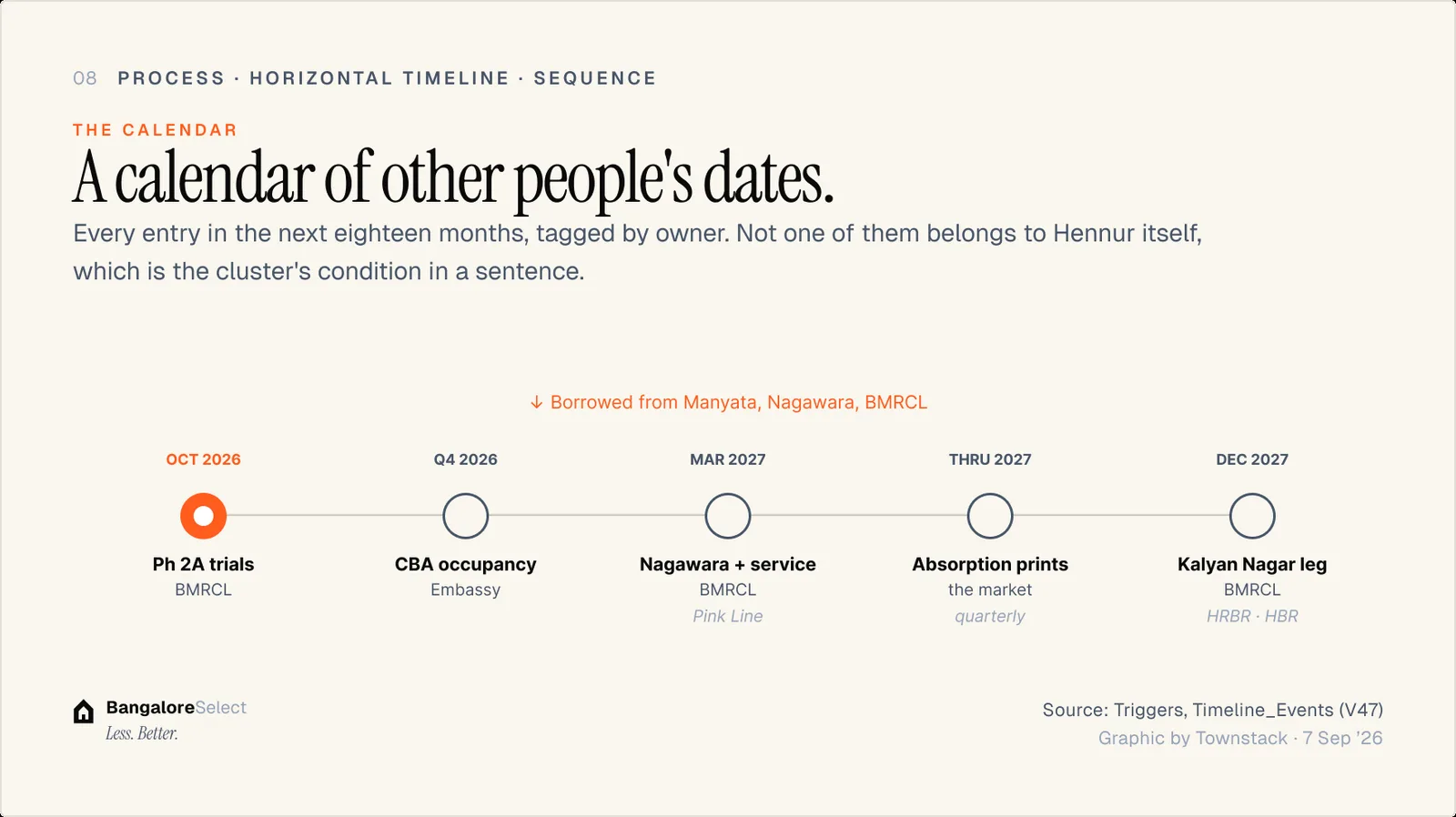

The calendar at a glance
October 2026: Phase 2A ORR trial runs begin, or the whole 2027 rail calendar starts drifting. Q4 2026: CBA occupancy at Manyata; watch Hennur's rental enquiries one quarter later. March 2027: Pink Line underground to Nagawara and Phase 2A revenue service, both feeding the interchange this cluster borrows until its own stations open. Through 2027: quarterly absorption prints on the ₹98 lakh-to-₹4.3 crore ladder against the corridor's supply weather. December 2027: Kalyan Nagar, HRBR, and HBR Layout stations: the date the cluster's map has been redrawn around, once.
Note what's missing: nothing on this calendar belongs to Hennur alone. Every entry is borrowed from Manyata, Nagawara, or the metro corporation, which is the cluster's condition in one sentence. Its own asset, Liveability 90, doesn't file progress reports.

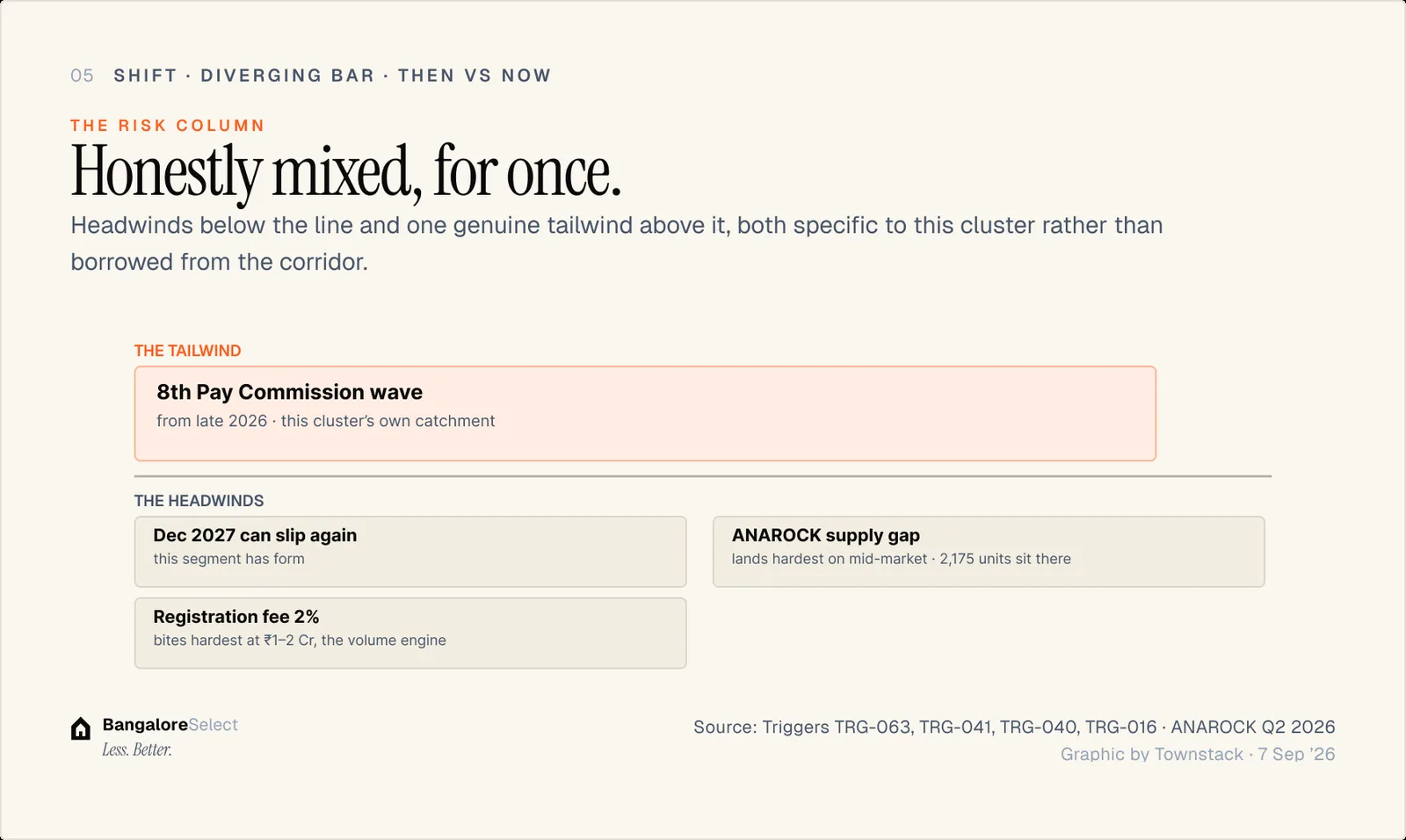

The risk column
The obvious one first: December 2027 has slipped once and can slip again: the segment's last public completion figure at the Hebbal end sat near zero, and this series does not extend Bangalore metro dates the benefit of the doubt. Price any Hennur purchase so that a mid-2028 opening doesn't change your decision.
Corridor-wide: the ANAROCK Q2 2026 supply-absorption gap (launches up 41 percent, sales up 1, unsold up 34) lands hardest on clusters with active mid-market inventory, and Hennur's 2,175 tracked units sit exactly there. The 2 percent registration fee bites hardest at the ₹1-to-2 crore entry tier, this cluster's volume engine. And the 8th Pay Commission demand wave, if it arrives from late 2026 as pencilled, cuts the other way: a tailwind specific to this cluster's government-employee catchment. Mixed column, honestly mixed.

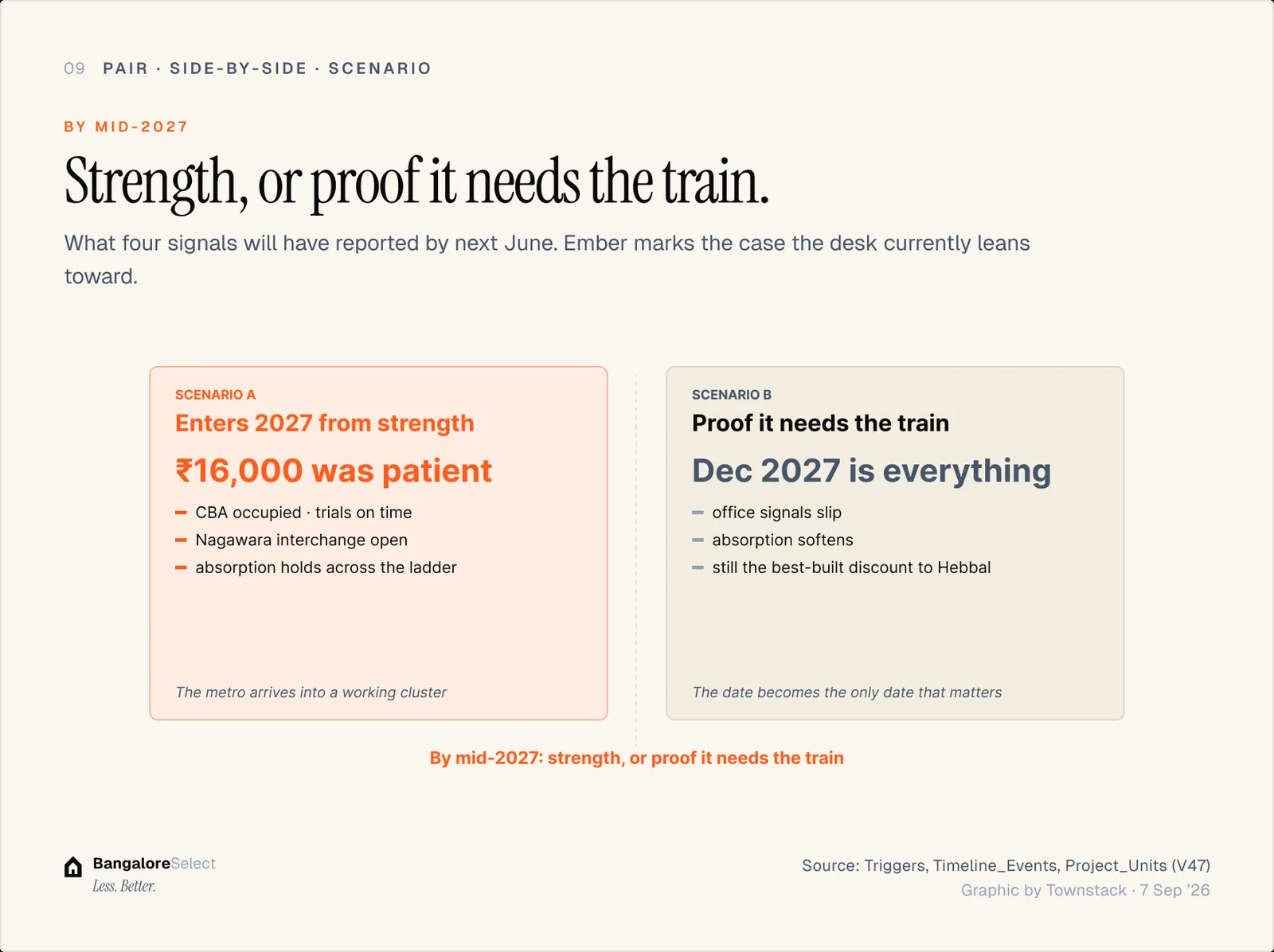

What you'll know by mid-2027
By next June the cluster will have reported: CBA occupied or slipping, Phase 2A trials run or not, Nagawara interchange open or resettled, and two quarters of absorption data on the ₹98 lakh-to-₹4.3 crore ladder. If the office signals land and absorption holds, Hennur enters the metro's arrival year (whenever it truly is) from strength, and today's ₹16,000 will have been the patient entry.
If they don't, the cluster is still the best-built discount to Hebbal on the map. It will simply have proven it needs the train after all, and December 2027 will have become the only date on this page that matters.
